Continual challenges can’t stop the Element hotel project

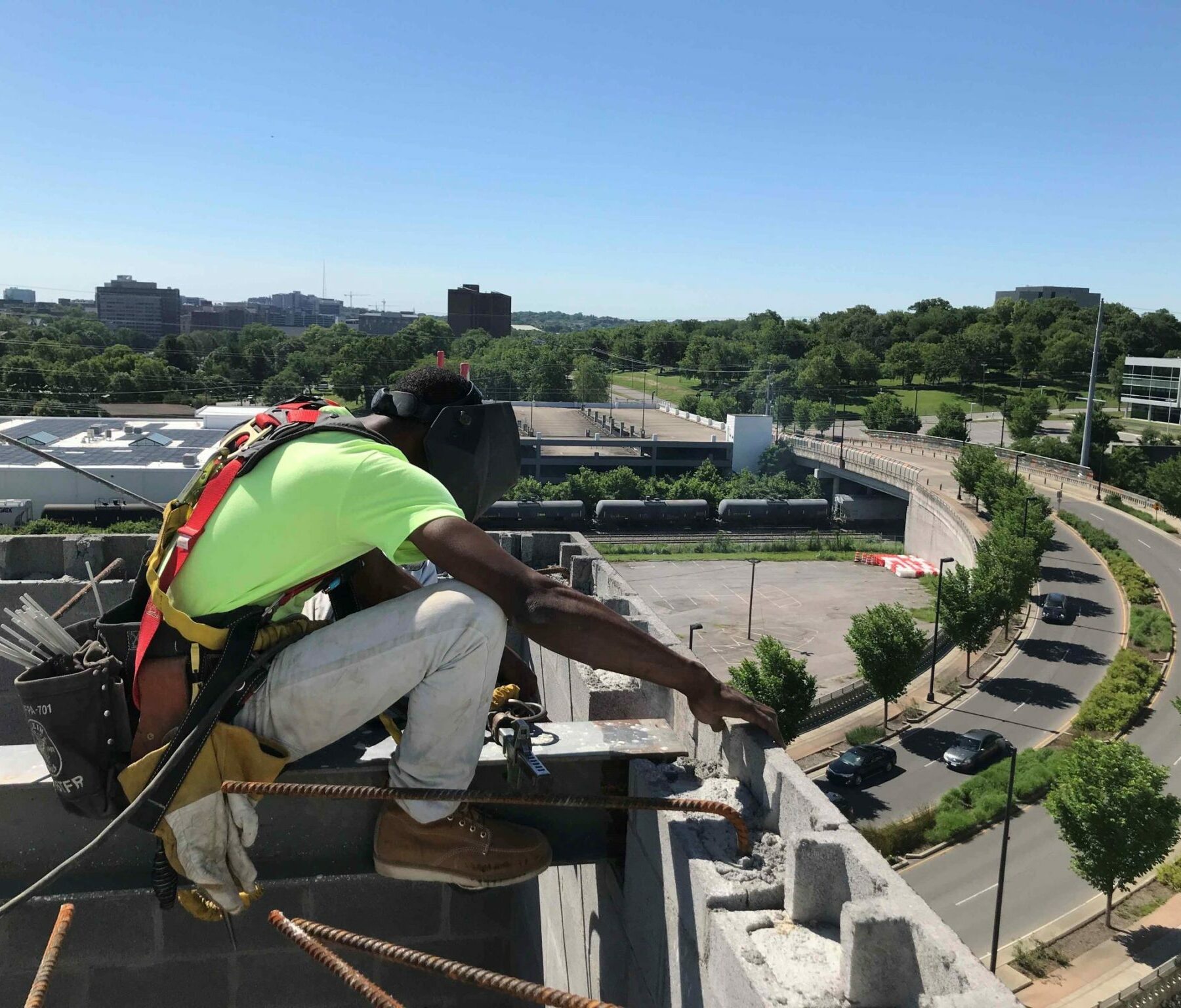

Crain construction worker on scaffolding at the element hotel job site

NASHVILLE, Tenn. — Neither delayed materials, workers out with the virus, or a Christmas Day bombing could stop construction on Element Nashville Vanderbilt West End hotel.

There was a domino effect of continual challenges while Crain Construction was building the 175-room, 6-story hotel at oneC1TY. So, our team adapted and changed the construction process.

A LEED-certified hotel with ground-floor retail space, Element is located on a 1.4-acre brownfield site where a lumber yard once stood. Crain Construction crews are accustomed to working on tight sites and this one bumps up against 28th Avenue, which provides the only street access.

Faced with logistical constraints, the project team coordinated carefully with the businesses, residents, and special events that are part of the vibrant oneC1TY community.

Site work included drilling 84 caissons down to solid rock, some 8-20 feet, to stabilize the soil. During the process, crews uncovered railroad ties from old train tracks buried six to seven feet underground.

The hotel is five floors of prefabricated stick framing on a concrete podium that bears on caissons. Anticipating price increases, Crain Construction purchased wood early, saving the client thousands of dollars. Prefabricated walls shaved a month off installation.

As the project was coming out of the ground COVID-19 arrived. Workers got sick, and factories closed, causing a multitude of material delays. The team kept the project moving by installing materials as they arrived.

“Whatever we could get first, we started on it even though it wasn’t in the typical order we would build,” said Chad Thomas, Crain Construction project manager. “We had seven different panel profiles, all coming from different factories and much of them were delayed.”

Paint coming from Italy was delayed so wood panels to be hand-painted in Nashville were put in later instead of in the normal order. Pavers and roofing were already installed so swing stages were used along the 28th Avenue side while working on the exterior walls instead of the usual scaffolding and lifts.

The coronavirus slowed permitting and then the Christmas Day bombing kept inspectors busy reviewing buildings and elevators damaged on Second Avenue. To help speed the client approval process, Metro inspections were videotaped and sent to the client so they wouldn’t have to be onsite during the coronavirus.

“With the coronavirus, material delays, and the Christmas Day bombing, it’s been the most challenging project I’ve had in 20 years,” said Thomas. “But the owners are happy, the building looks great, and guests are booking rooms.”

Element Nashville Vanderbilt West End is operated by Aimbridge Hospitality. Atlanta-based Noble Investment Group is the developer and Niles Bolton Associates, also headquartered in Atlanta, are the architects for the project.

Related Projects

Lipscomb Pharmacy Exterior after construction
Construction Best Practices for Medical Offices: Insights from Crain Construction

Building a medical office facility isn’t just about bricks and mortar. It’s about creating a space that supports efficient patient care and maximizes your practice’s profitability. Often, that intentionality comes with its own set of unique challenges. From adhering to strict regulatory standards to coordinating specialized systems and equipment, there’s a lot to juggle. And...

Gary New, Crain Construction’s Preconstruction Manager
Employee Spotlight: Gary New

Gary New, Crain Construction’s Preconstruction Manager, has built an impressive career in the construction industry, marked by his dedication, expertise, and people-first approach. Since joining Crain 15 years ago, Gary has applied his extensive experience across various roles and industries, helping Crain continue to exceed client expectations. His current work includes overseeing preconstruction for the...

construction workers in hard hats working on a building project
Modern Construction Safety Techniques at Crain Construction

Over the last few years, we’ve seen a big shift in the industry: safety has become a real priority for everyone involved. Instead of simply meeting the basic requirements of OSHA or TOSHA, companies are stepping up and being proactive about safety. From training programs to new technologies, everyone is looking for ways to keep...

commercial building under construction
From Unstable to Unshakable: Solving Ground Issues in Commercial Construction

When it comes to commercial construction, ensuring the stability and integrity of the ground beneath a structure is a foundational step. Ground stabilization is the process of preparing the soil to support a building or structure effectively, and it plays a crucial role in the safety and longevity of any project. However, it can also...

Community

We partner with organizations to invest, give back and make a positive impact on the communities where we live and work.

Blog

Get the latest Crain Construction Blogs and interesting insights about our projects and community endeavors here.

When you’re ready to build, we’re here for you

Reach out to start a conversation with our team.
